System description
Approval/suitability
All leak detection equipment/leak detectors in use must
comply with the basic criteria laid down for construction and
testing standards. All such preconditions which could have a
bearing on the functional and operative safety of the system
must therefore be observed.
It therefore goes without saying that the conditions for oper-
ative use have been tested by the competent authorities and
clearly defined and set down in the documents of approval
issued by them.
Double-walled piping with leak monitoring is an approved leak
detection equipment/leak detector system.
Example: a fuelling station
Each plant can be assembled to fit the needs of the individ-
ual situation by combining elements of several monitoring
systems.
Two-line system
A monitoring lead runs from the positive pressure leak
detector DLR-G 1-7 to the distributor block and from there
to lines 1 and 3.
Ring line
The double-walled pipes 1 and 2 are connected one after the
other with a monitoring lead. A test valve PV is installed at the
end of the double-walled pipe. If a vacuum leak detector is
used, a monitoring lead runs back to the device.
The advantages of the system
Using double-walled FLEXWELL® Safety Pipe with leak
monitoring offers, besides a high degree of operative safety,
substantial economic advantages:
- the entire system can be easily and simply monitored at any
time without interrupting operations
- requirements such as e.g. pressure/volume measurements,
pressure tests or route surveys can be dispensed with
- when a leak occurs, operations can normally be continued
without interruption; repairs can be planned.
Single-line system
The double-walled line no. 4 is also monitored. A test valve PV
is similarly installed at its end.
Operating limits
- pressure range (acc. to pipe system and monitoring)
- maximum monitorable pipe length see Worksheets
LDS 8.120 and LDS 8.130
- distributor block 2 – 8 connections

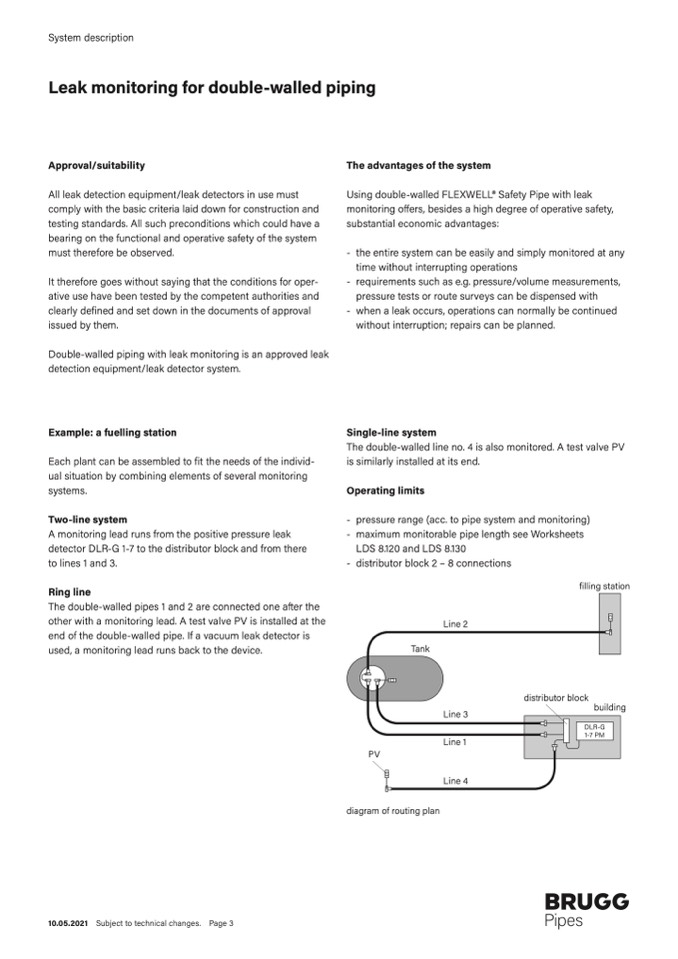

Line 2
Tank
Line 3
Line 1
Line 4
filling station
distributor block
building
PV
DLR-G
1-7 PM
10.05.2021
Subject to technical changes.
Page 3
diagram of routing plan
